Question

Has anyone successfully implemented a multi-level Master Schedule structure where a MS Level 1 part's structure includes a MS Level 1 subassembly/ component that has its own forecast?

  • April 22, 2026
  • 1 reply
  • 31 views

Vernon Anderson
Sidekick (Employee)
Forum|alt.badge.img+8

I always avoided this situation and used MRP Spare Parts Forecast for the lower level forecasts.  Ideas?  Thoughts?  Cautions?

1 reply

majose
Hero (Employee)
Forum|alt.badge.img+14
  • Hero (Employee)
  • April 22, 2026

Hi Vernon,

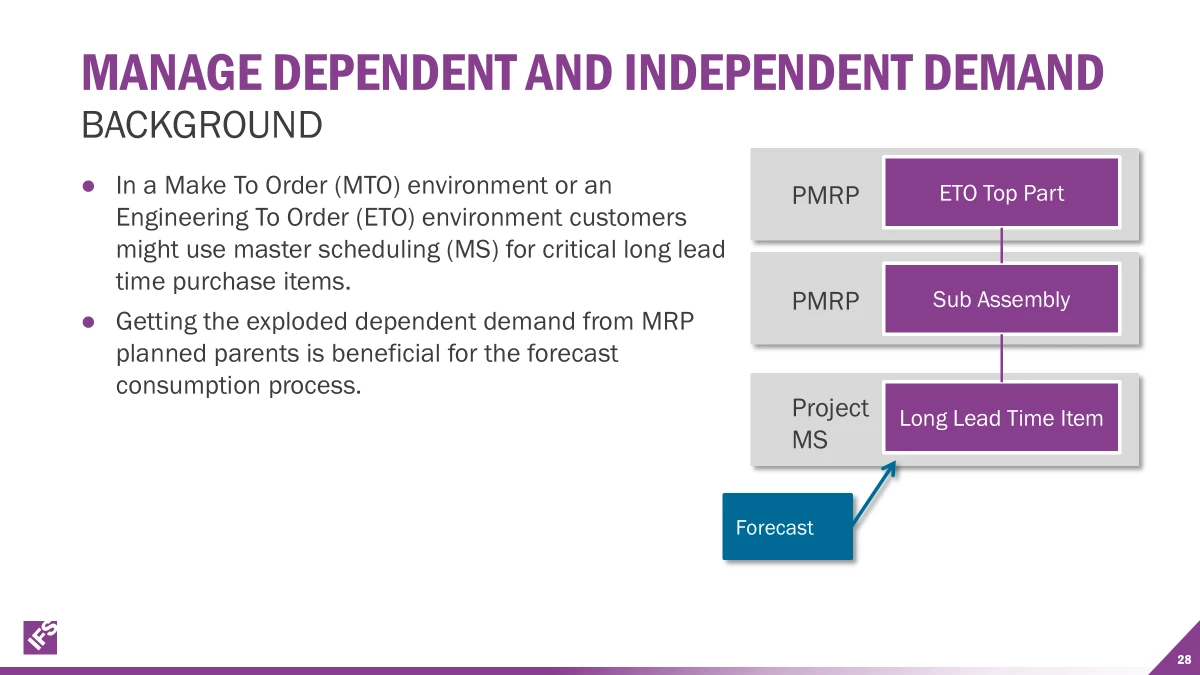

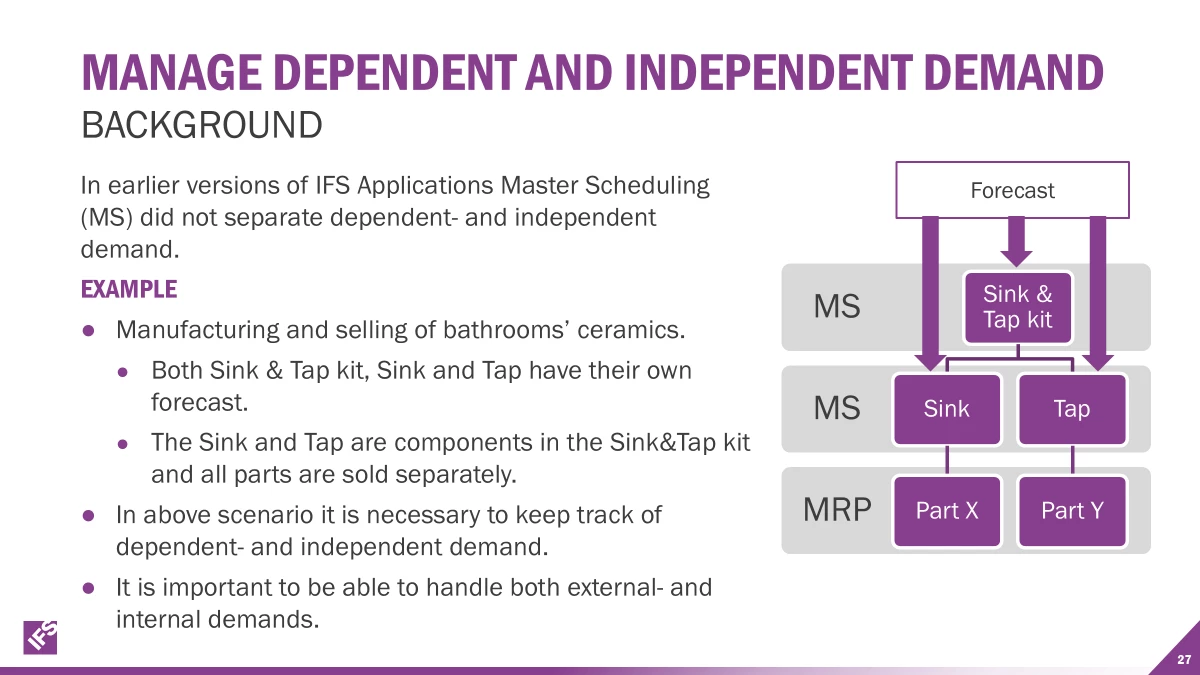

In Apps10 - Master Scheduling we introduced:

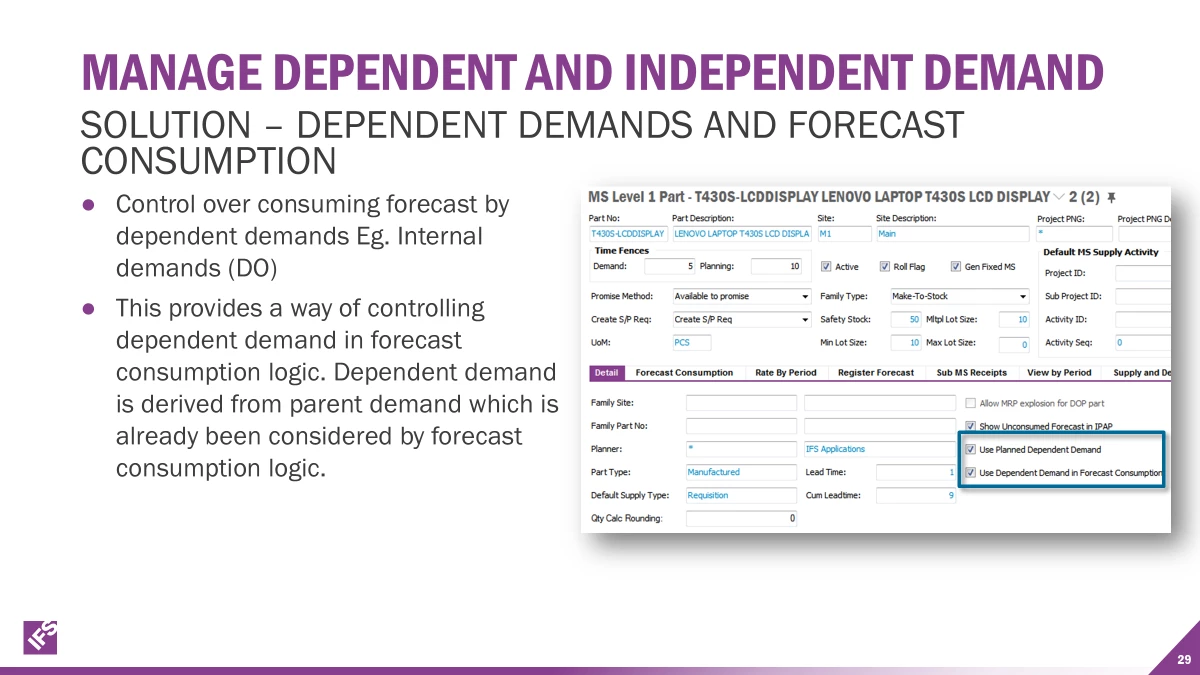

So in above case, if I sell Sink separately and have forecast figures for the sink and that forecast is only covering when I sell the Sink separately (oboy I am repeating myself) then I will USE Planned Dependent Demand but I will NOT USE Dependent Demand in Forecast Consumption.

Because:

  • I want the exploded planned demand from parent ms planned part (the exploded MPS), so that this contributes to the projected onhand equation, and drive my MPS for the Sink.
  • But I don’t want the exploded demand (coming from Sink&Tap kit Part No) to consume my forecast for the Sink Part No.That exploded demand IS not part of my statistical forecast in this example.

Run a site MS Level 1 calculation (it orders by Low Level code)

OR

parent MS part first and then child MS part

Hope this helps

-Mats
