In aviation, we need to do month FMS database uploads.

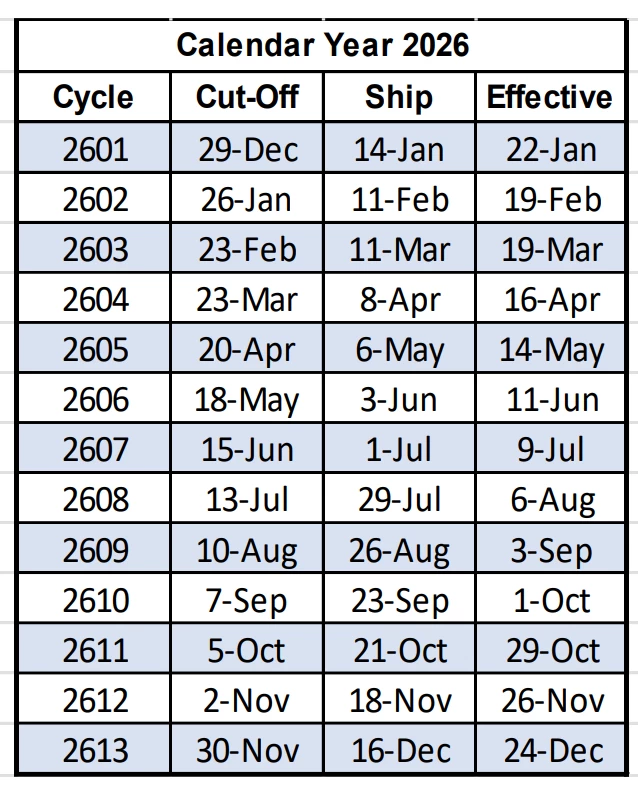

They come out every 28 days :
- May 29th, 2026
- June 26th, 2026
- July 24th, 2026
- August 21st, 2026
- etc

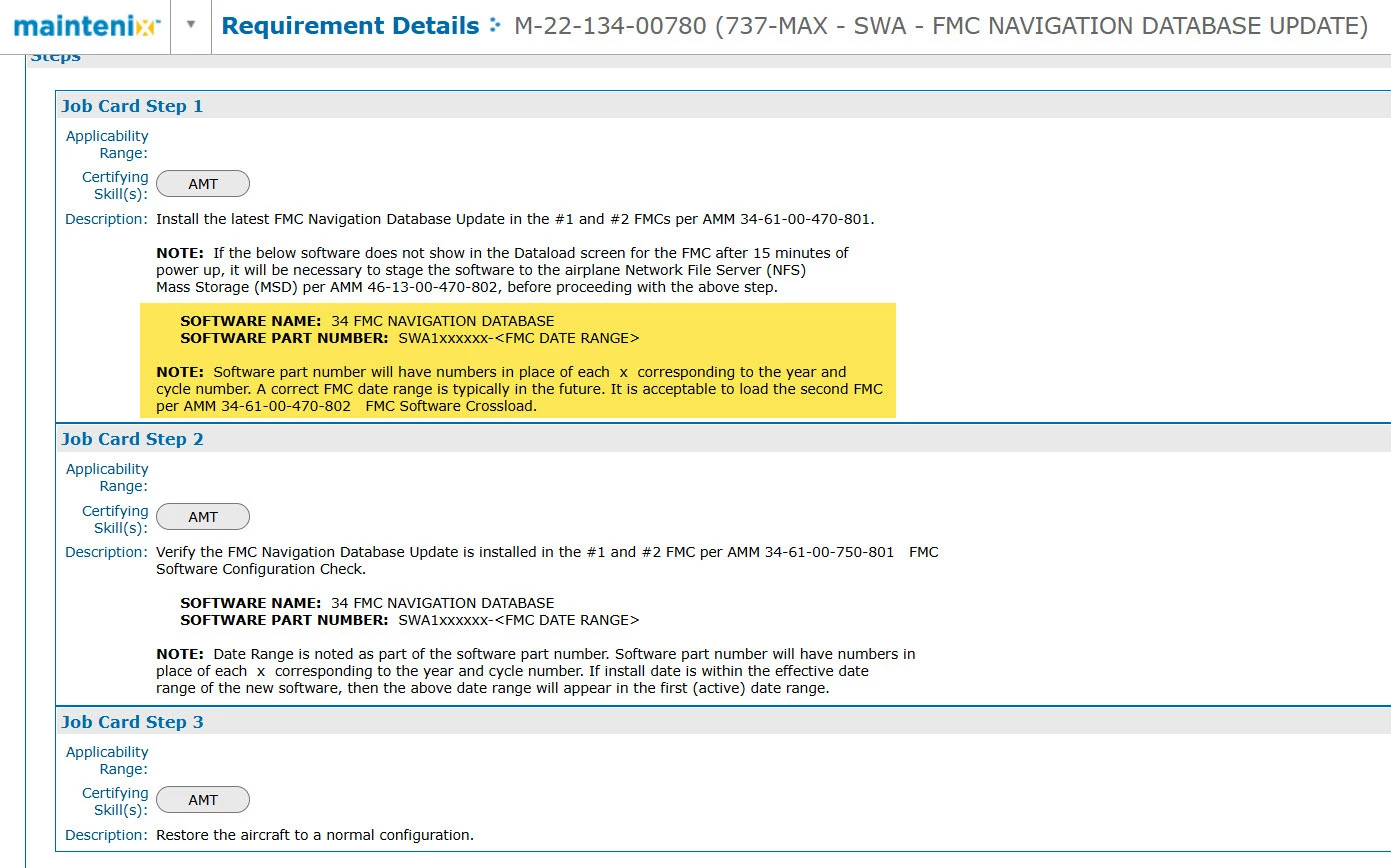

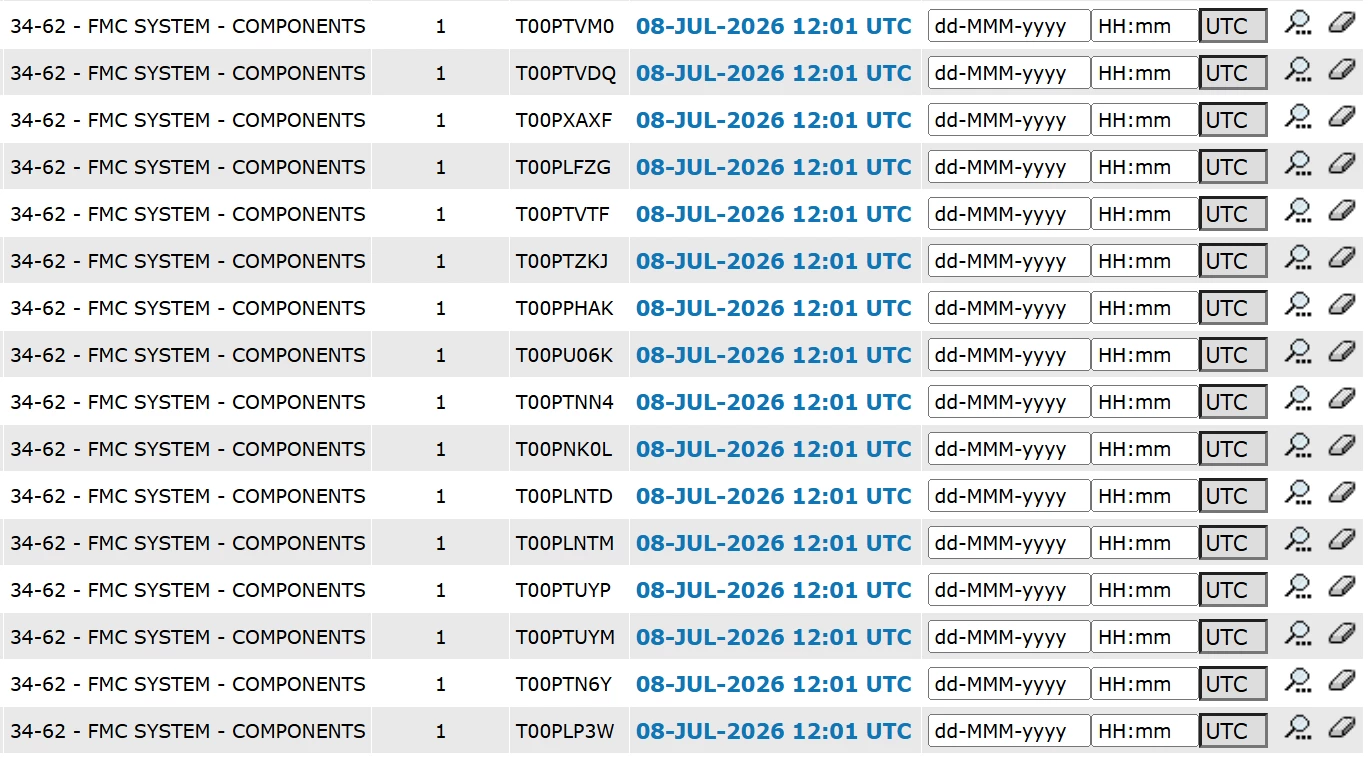

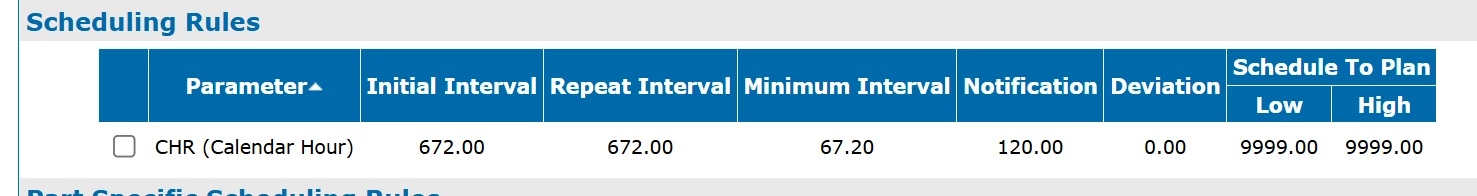

In MXI, to set up a task to track it like this, will need a different REQ for each month.
That takes a long time to manage the fleet to put a new task for every month to be able to track the FMS Database with the correct release dates and due dates.
How do other airlines who use MXI set up their FMS cycles per month?
