Question

Project Currency Errors

  • July 3, 2026
  • 3 replies
  • 15 views

Forum|alt.badge.img+1

When trying to create a project forecast with Snapshot we are getting the below error

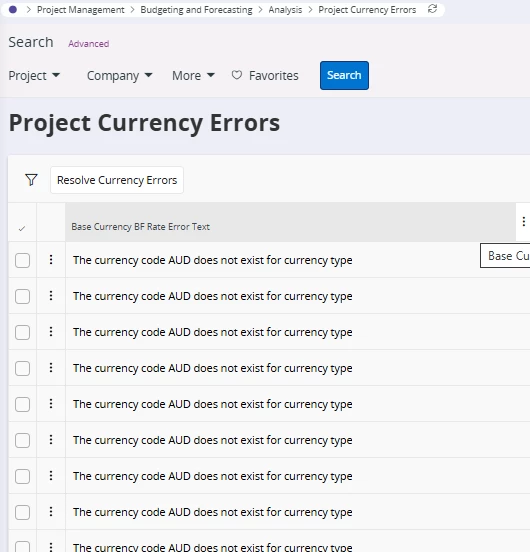

There are >1000 currency errors with the below text.

Currency rates are also updated



3 replies

Forum|alt.badge.img+20

Hi,

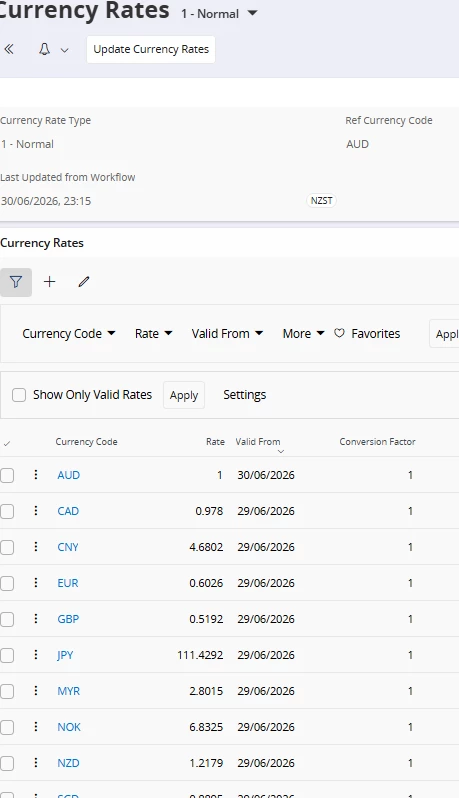

You show rate type 1 in the image with AUD.   Check the “other” rate types.

Also, consider a rate that as I would describe is older than dirt.  Some areas of IFS use a concept similar to backwards scheduling where a date validation can be older than anticipated.

Suggestion 1) set a new rate that is old for AUD maybe going back a few years or more just to be safe. 2) Check the other rate types.



This will / should solve that error,

Best regards,

Thomas


Forum|alt.badge.img+1

Hi ​@Thomas Peterson



Thank you for you reply. I added a AUD rate for 1990 in Rate type 1

These are the other two rate types




Forum|alt.badge.img+20

Hi,



Did you add the AUD to all rate types including rate type 3?  Again, use old date as you did in rate type 1.

I assume you are not using rate type 2, but given it takes a few seconds to set up a rate for AUD, if you still have issues after rate type 3, add a rate to rate type 2.
