We are currently using PMs with Performed Date Based set to Yes. We have a customer scenario where this setting needs to be changed to No.
Our plan is to enable Revision Control and make the change to the active PMs. However, these PMs already have work orders (WOs) generated, and the WOs are in different statuses.

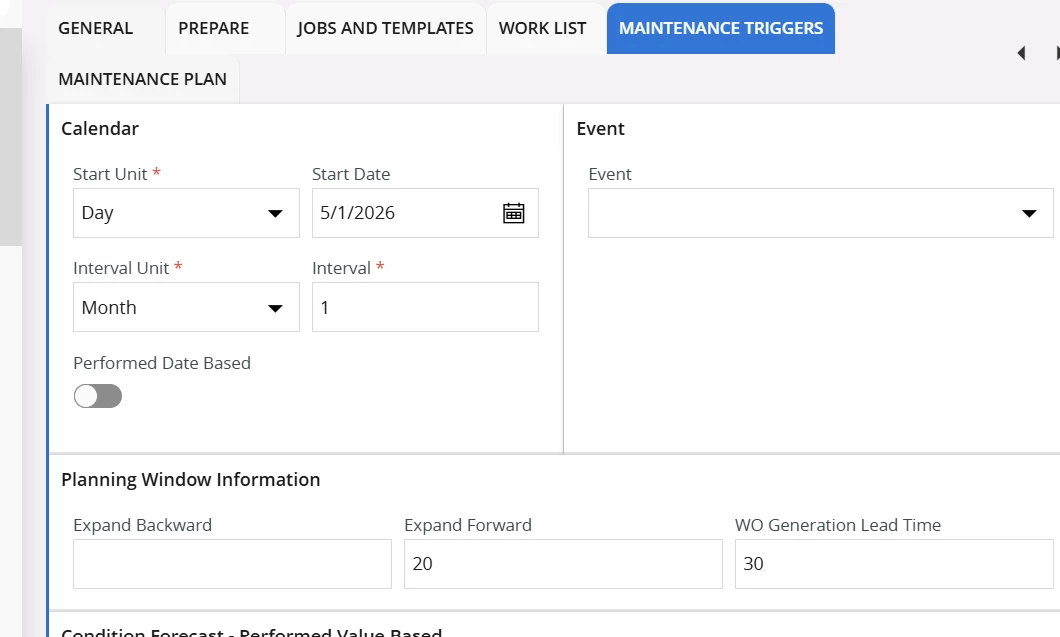

When we change Performed Date Based to No, the system adjusts the plan based on the Valid From date and Calendar criteria.

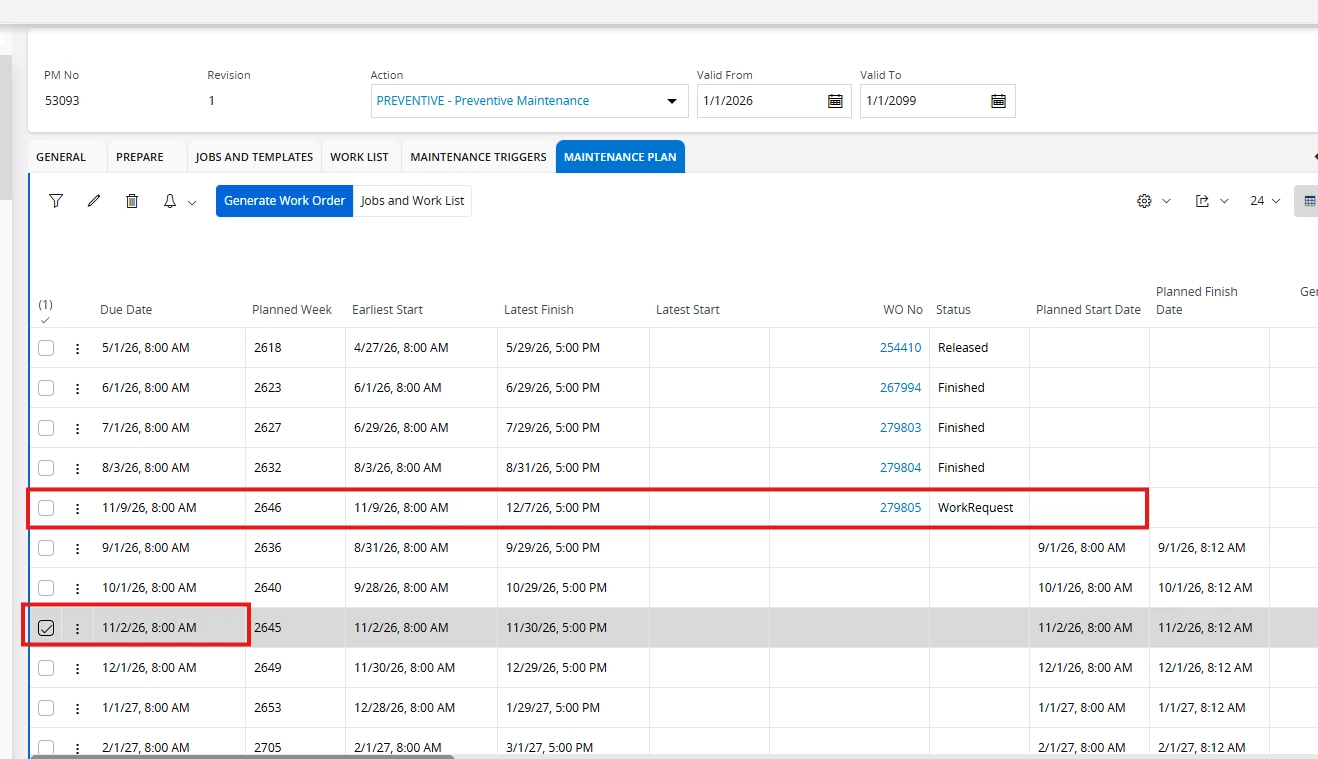

In this concerned scenario, WOs have been generated for future maintenance periods as their lead time (30-day in below example). It looks like the system skips the months where the WOs are already in Finished status, as expected. However, it creates duplicate plan lines for months where a plan line already exists with an associated WO in Released status.


Please help to understand the best options other than marking duplicated lines Generatable = No
